Balcon Studio

On site now

A 1,500 m² villa in Dubai

A detached villa taken from demolition to handover: new layout, all services replaced, marble inlaid into the parquet and ceilings painted by hand. Work is on site now.

Project facts

Emirate
Dubai
Type
Detached villa
Area
1,500 m²
Bathrooms
5
On site since
February 2026
Handover
November 2026
Build programme
10 months
Design stage
3 months

The villa also has swimming pool, lift, majlis, staff quarters. The owner is not named and the community is not identified.

What was there before

The villa as it stood before work started. The layout, the services and every finish in these rooms were taken out and replaced.

  • Library with timber shelving, a crystal chandelier and a tall arched window

    Before: the library

  • Staircase hall with a wrought-iron balustrade and a polished stone floor
    Before: the staircase hall

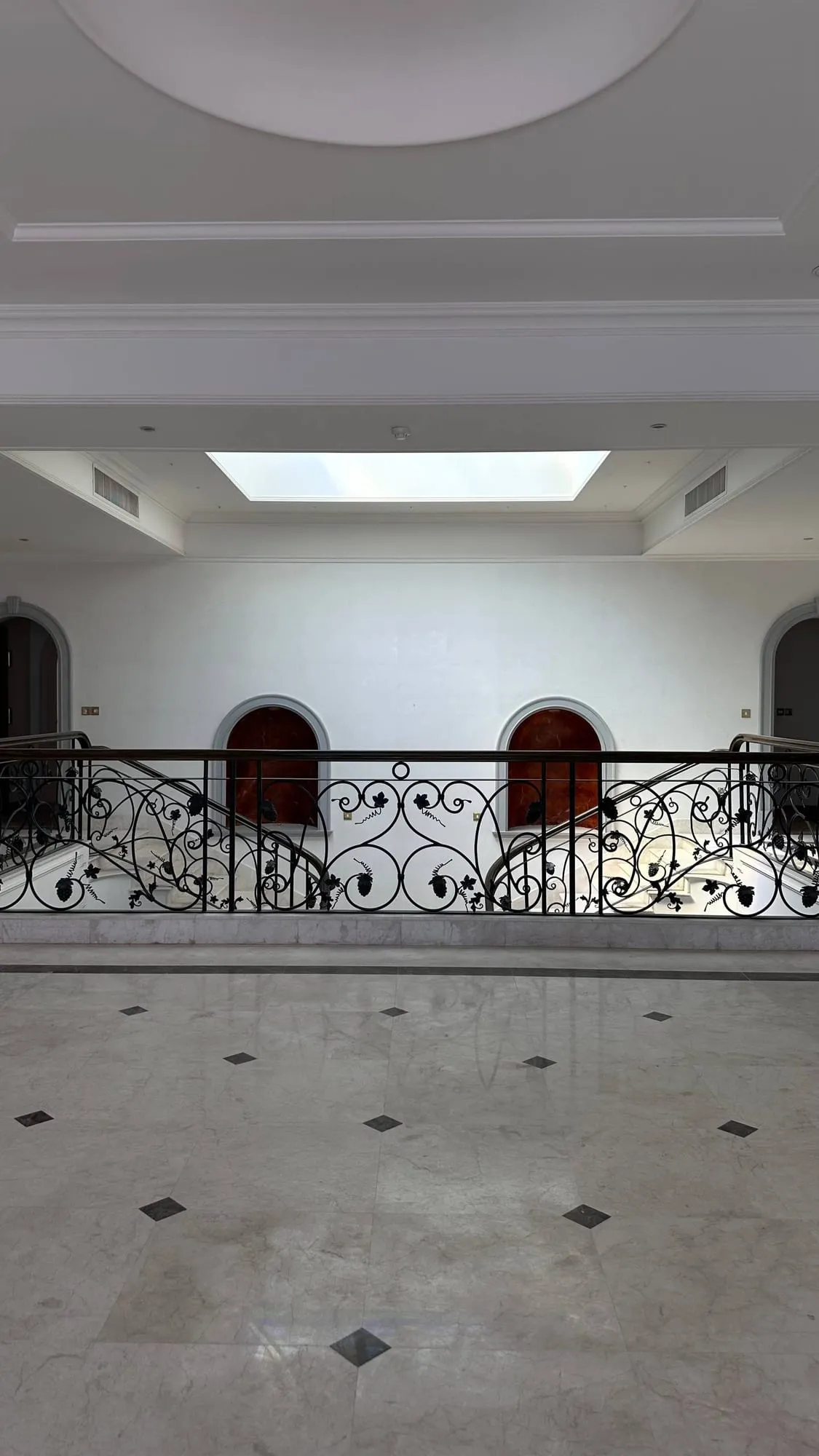

  • Upper gallery with a skylight, arched doorways and an iron balustrade
    Before: the upper gallery

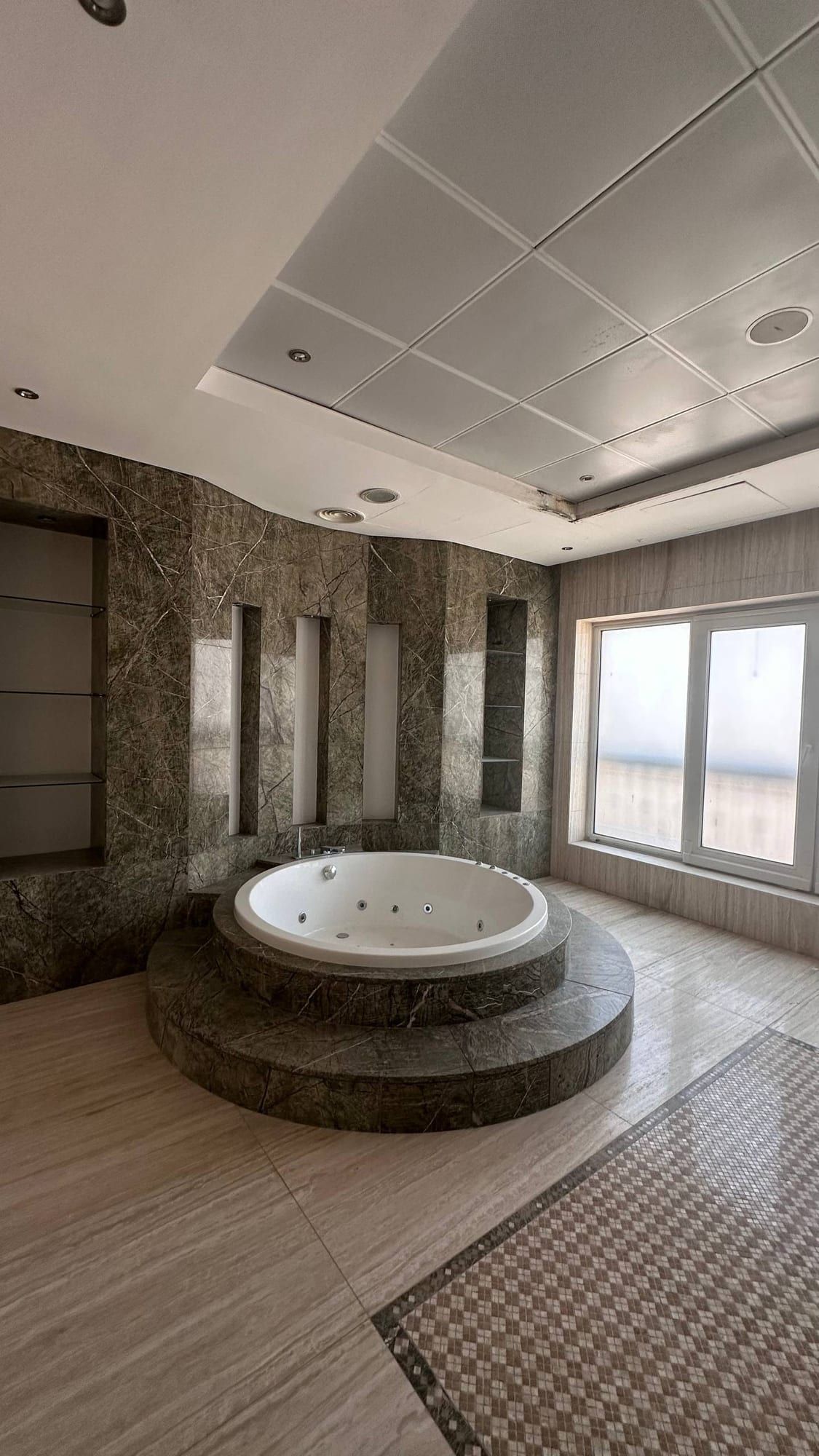

  • Bathroom with a raised round tub clad in stone and a tiled floor
    Before: a bathroom

Everything under one contract

On a villa this size the alternative is a designer, a foreman and five separate trades, with the owner holding the seams together. Here the whole list sits in one contract and one programme.

Part of the jobWhat it includes
Structure and layoutDemolition, new layout, partitions and plaster
ServicesElectrical, water, air conditioning, low-voltage and smart-home systems
FinishesFlooring, painting, ceilings and mouldings, tiling, lighting
Joinery and roomsBespoke joinery, kitchen, five bathrooms, furniture
Outside the wallsFaçade, landscaping, swimming pool

Where the work stands

Month 8 of 10 · painting, ceilings, tiling, mouldings

The longest stage, and the one where the villa starts to look like itself. Three-level ceilings are built and their mouldings run, tiling is set out so joints land where they should, and painted surfaces are prepared to a standard that will hold under the ceiling artwork.

You can walk this site with us. Ask on WhatsApp and we will arrange a time that works for the crew.

Three months of drawing before anything is touched

On a villa this size the design stage is not a formality — it is where the cost of mistakes is at its lowest. Every decision postponed to the site gets made under pressure, by whoever is standing there.

  1. Month 1 · 1 mo

    Layout

    How the villa is used decides everything that follows: where the majlis sits relative to the family wing, how staff move without crossing guests, where the lift lands on each floor. Until that is settled, no service run can be drawn.

  2. Month 2 · 1 mo

    Visualisation

    Materials and light are decided here, on screen, where changing them costs a day rather than a demolished wall. Marble, veneer and finishes are chosen against each other rather than one at a time.

  3. Month 3 · 1 mo

    Working drawings

    The set a site can actually build from: every socket, drain, ceiling level and joinery dimension. This is the document that keeps the build from turning into a series of decisions taken on the spot.

From the visualisation to the site

The same spaces twice: as they were designed, and as they stand on site now. Ceilings, staircases and proportions were fixed in the visualisation, and the site is building to it.

Entrance hall

  • Entrance hall with a double staircase, iron balustrades and ring chandeliers
    Visualisation · Entrance hall

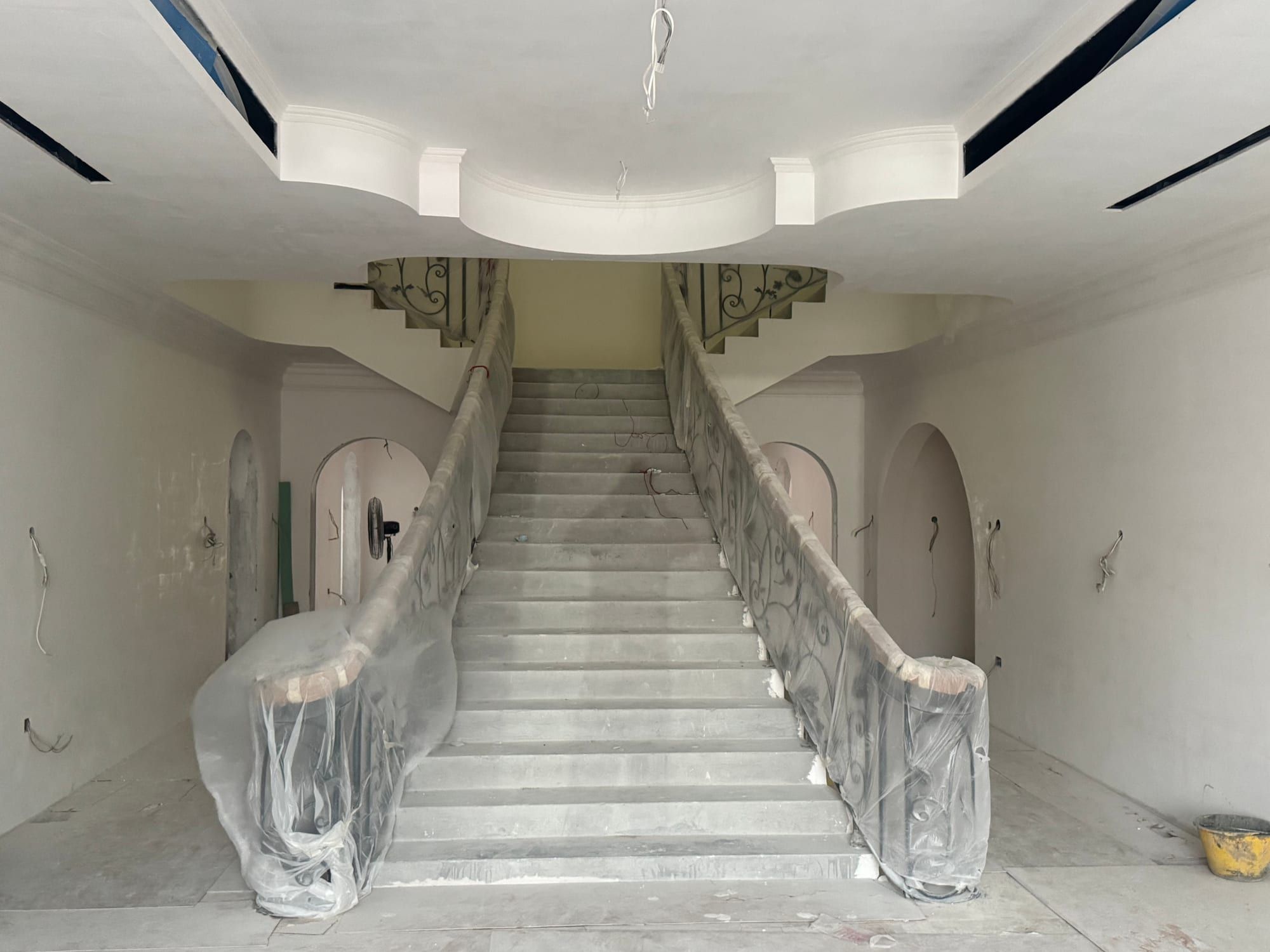

  • Double staircase under protective wrap in the entrance hall, with the stepped ceiling above
    On site, August 2026

Room with arched windows

  • Room with ornamental plaster on the ceiling, chandeliers and tall arched windows
    Visualisation · Room with arched windows

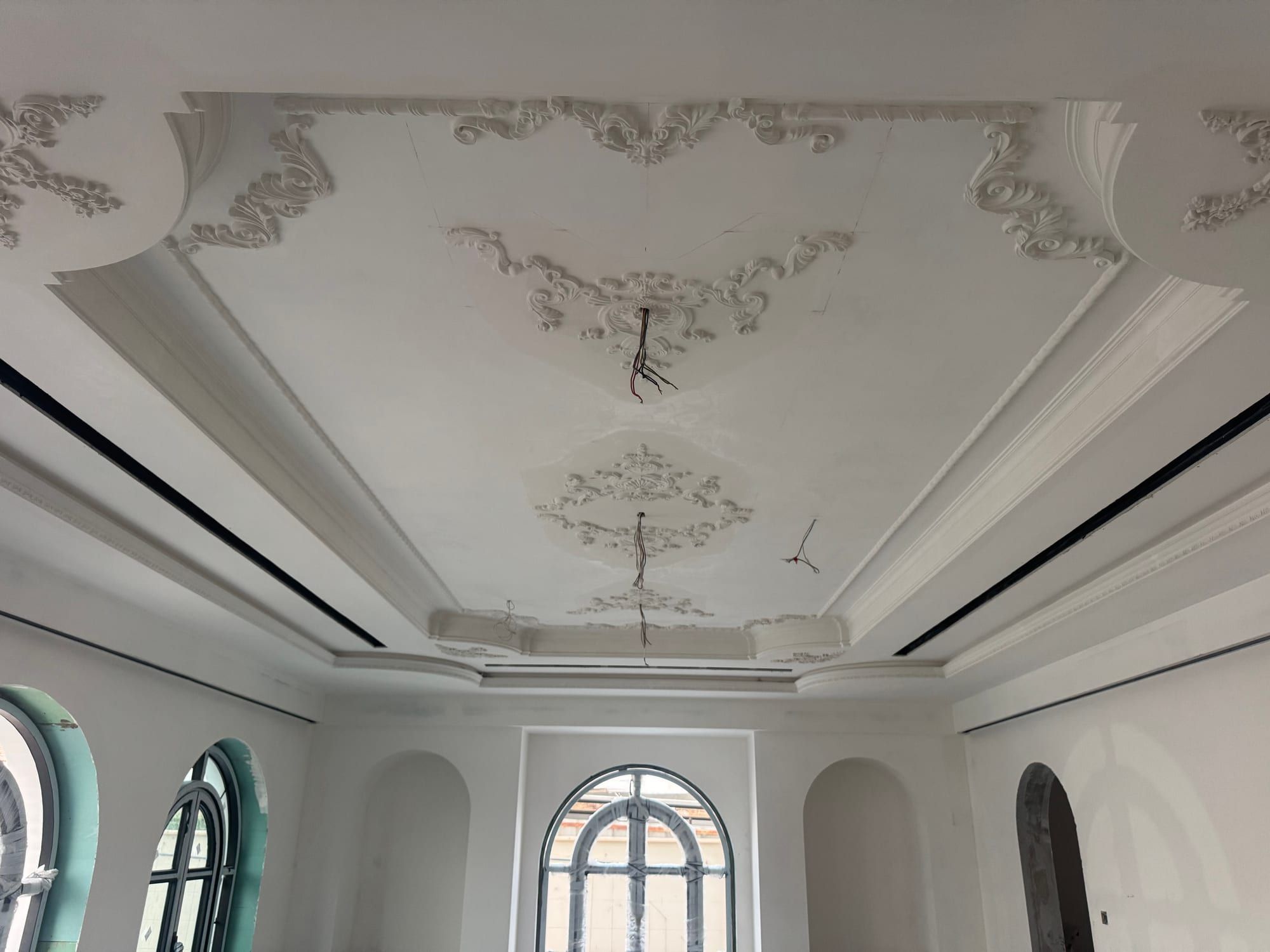

  • Ornamental plasterwork fixed to a stepped ceiling above a row of arched windows
    On site, August 2026

Upper gallery

  • Upper gallery with a coffered ceiling, a curved iron balustrade and seating

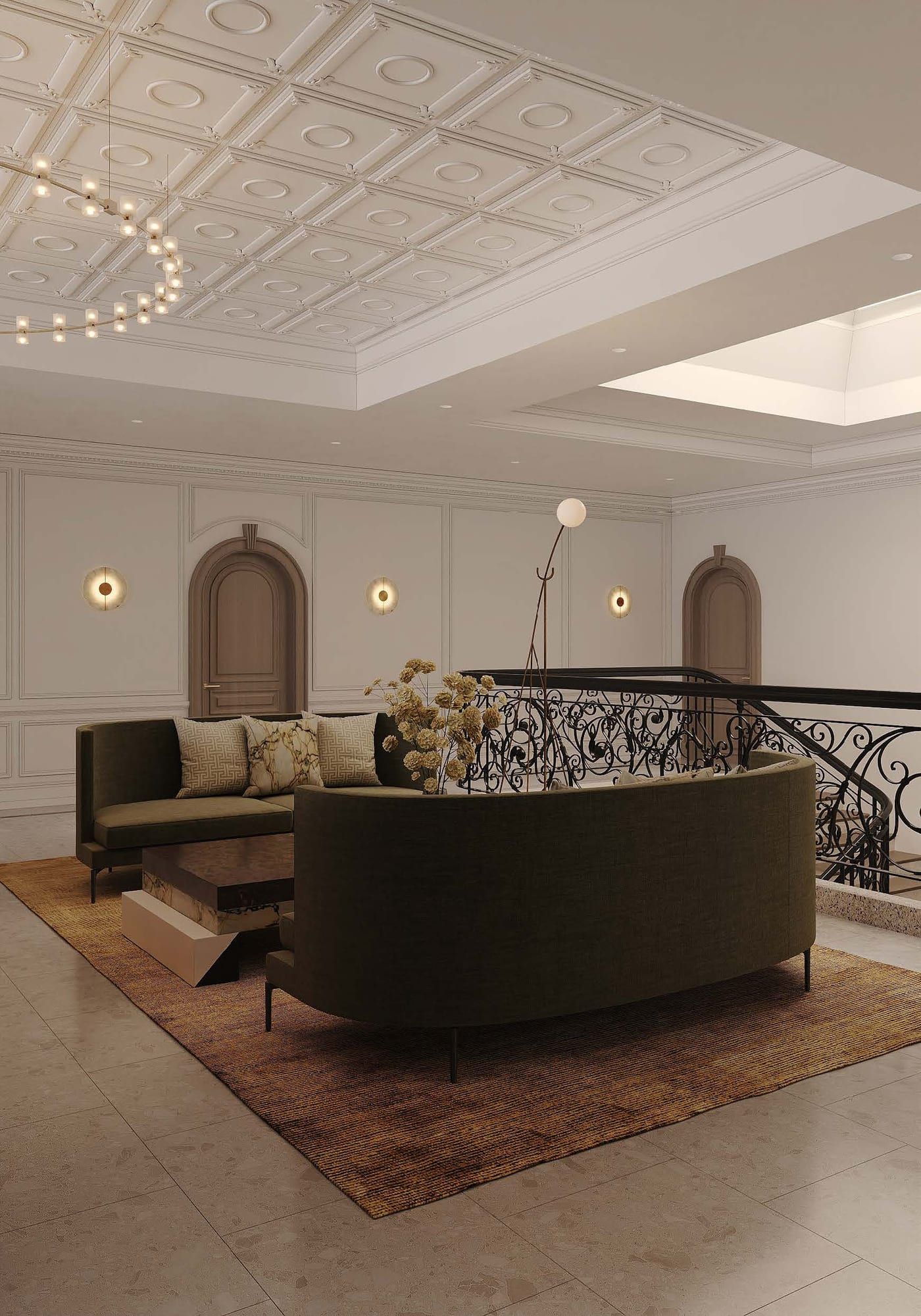

    Visualisation · Upper gallery

  • Coffered plaster ceiling over the upper gallery, above a curved balustrade and a stained-glass window
    On site, August 2026

Dubai Municipality approval for this villa took two weeks. It is submitted before demolition, not after — work started ahead of approval is the one mistake on a renovation that money cannot correct.

Ten months on site, in the only order that works

The sequence below is not a preference. Each stage closes something the next one cannot reopen without breaking it, which is why the stages that cost most to redo are the ones that get inspected before they disappear.

  1. Stage 1 · 1 mo · done

    Demolition

    Everything that will not stay comes out, and the villa is stripped back to structure. This is also when the building tells you what the drawings did not: where a slab is thicker than recorded, where an old service run is hiding.

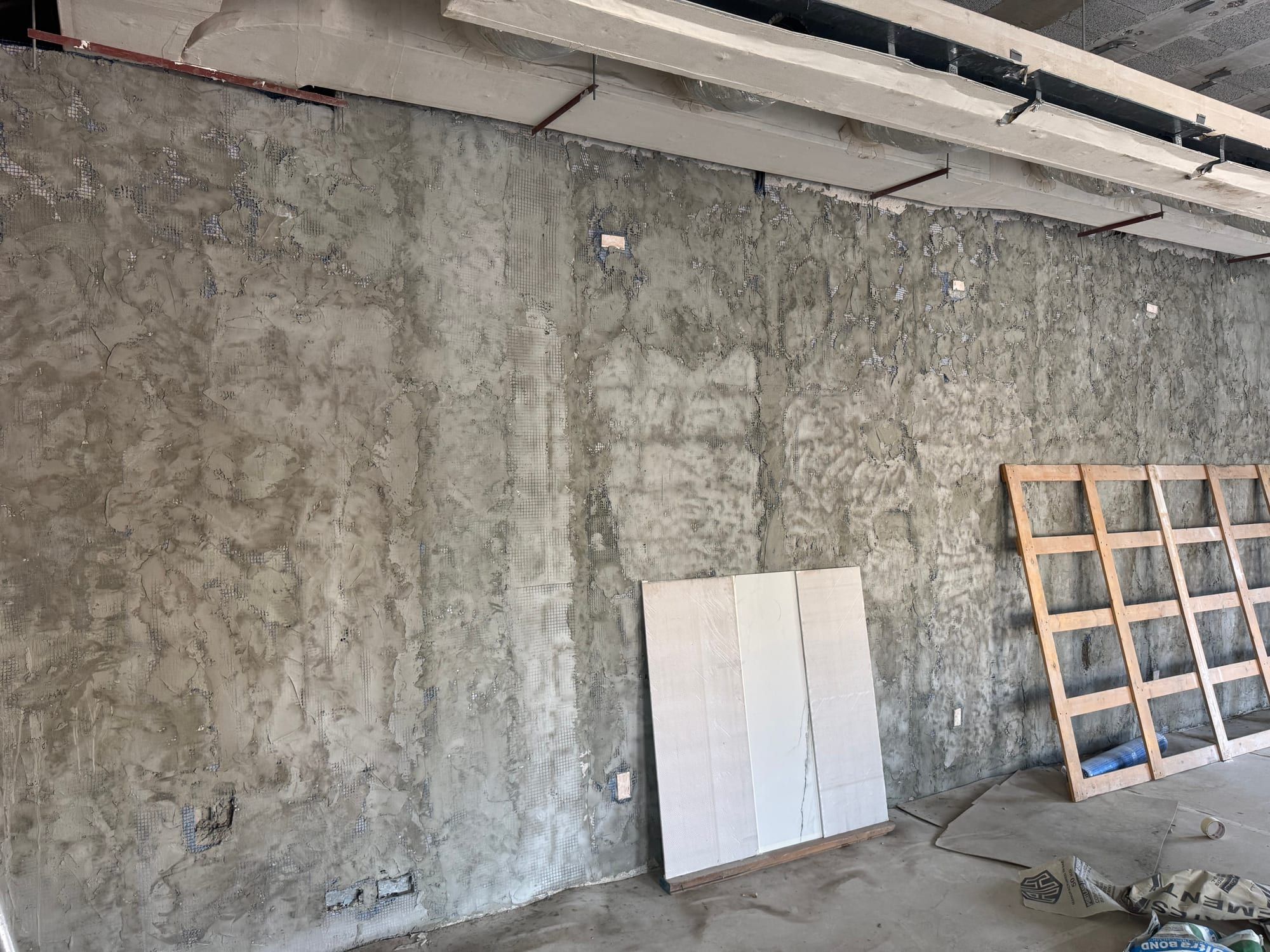

    • Internal wall with the old plaster removed down to bare blockwork, loose panels leaning against it
      Old finishes taken back to the block

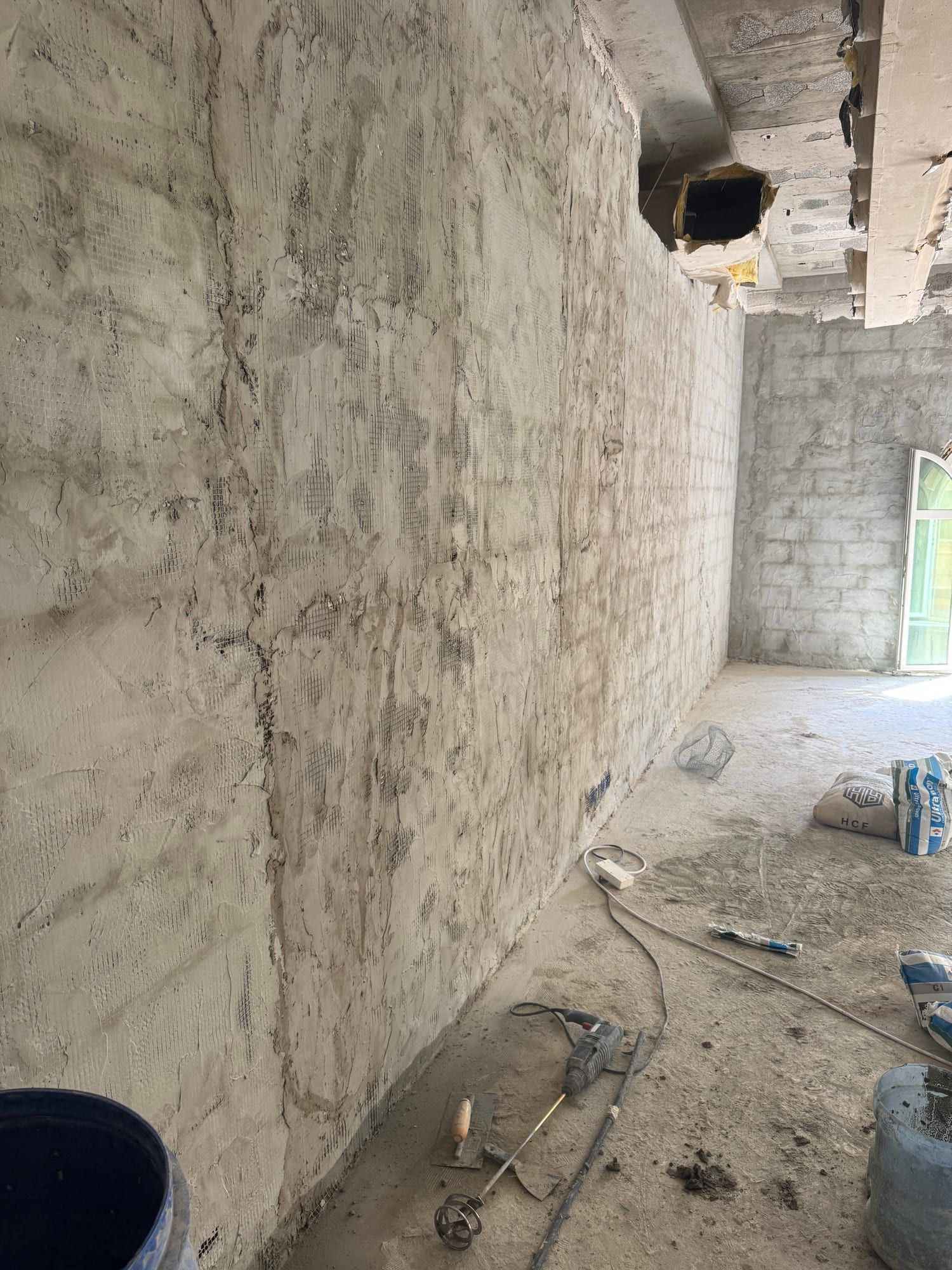

    • Long wall stripped of its surface, showing blockwork and patches of old render along its length
      What the walls looked like once the old surfaces came off
  2. Stage 2 · 2 mo · done

    Partitions and plaster

    The new layout is built in blockwork and plastered. Walls go up before services because the routes are chased into them; getting this order wrong means opening finished surfaces later.

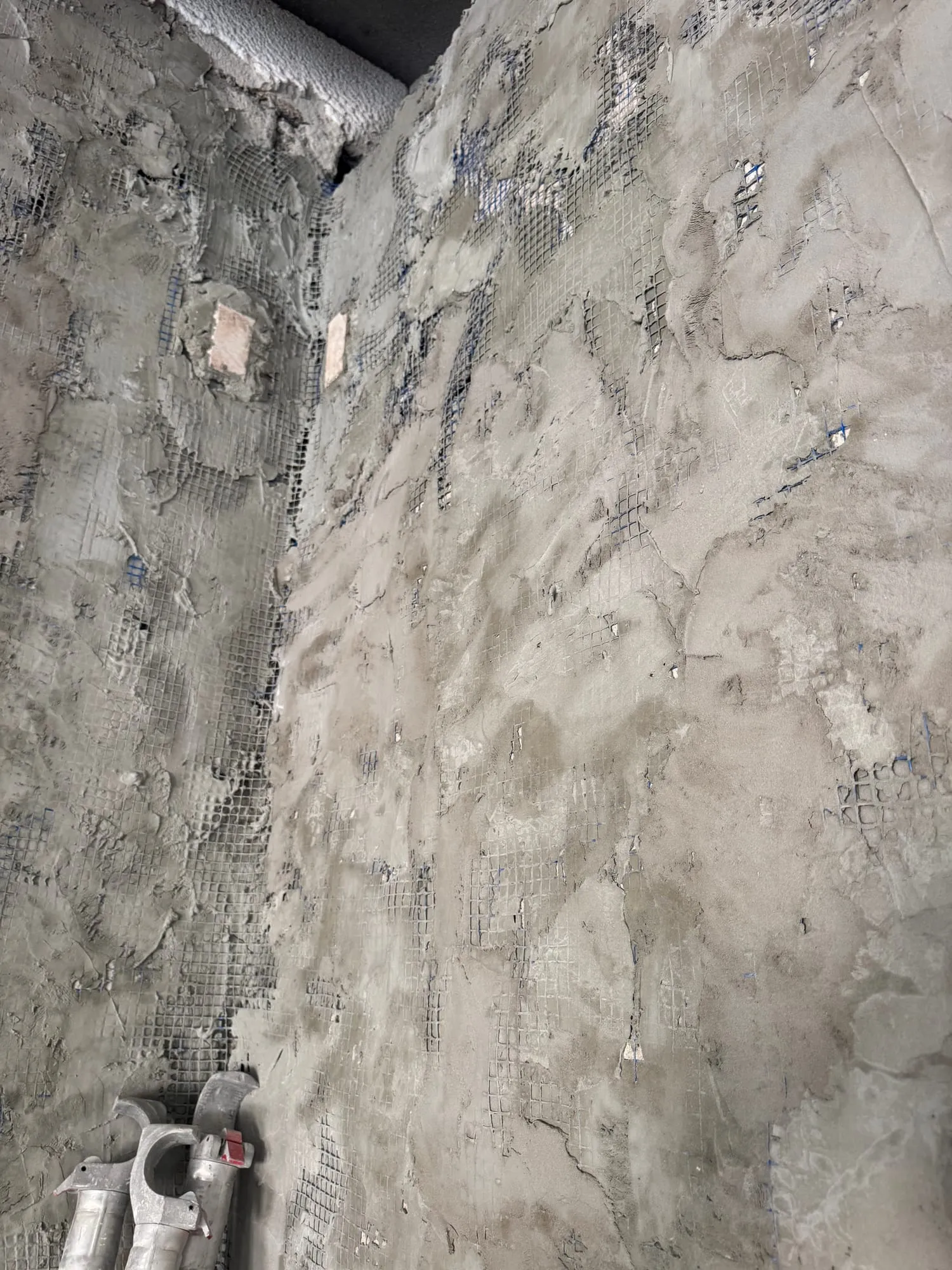

    • Corner of a wall where fresh plaster is being applied over reinforcing mesh
      Plaster going on over reinforcing mesh

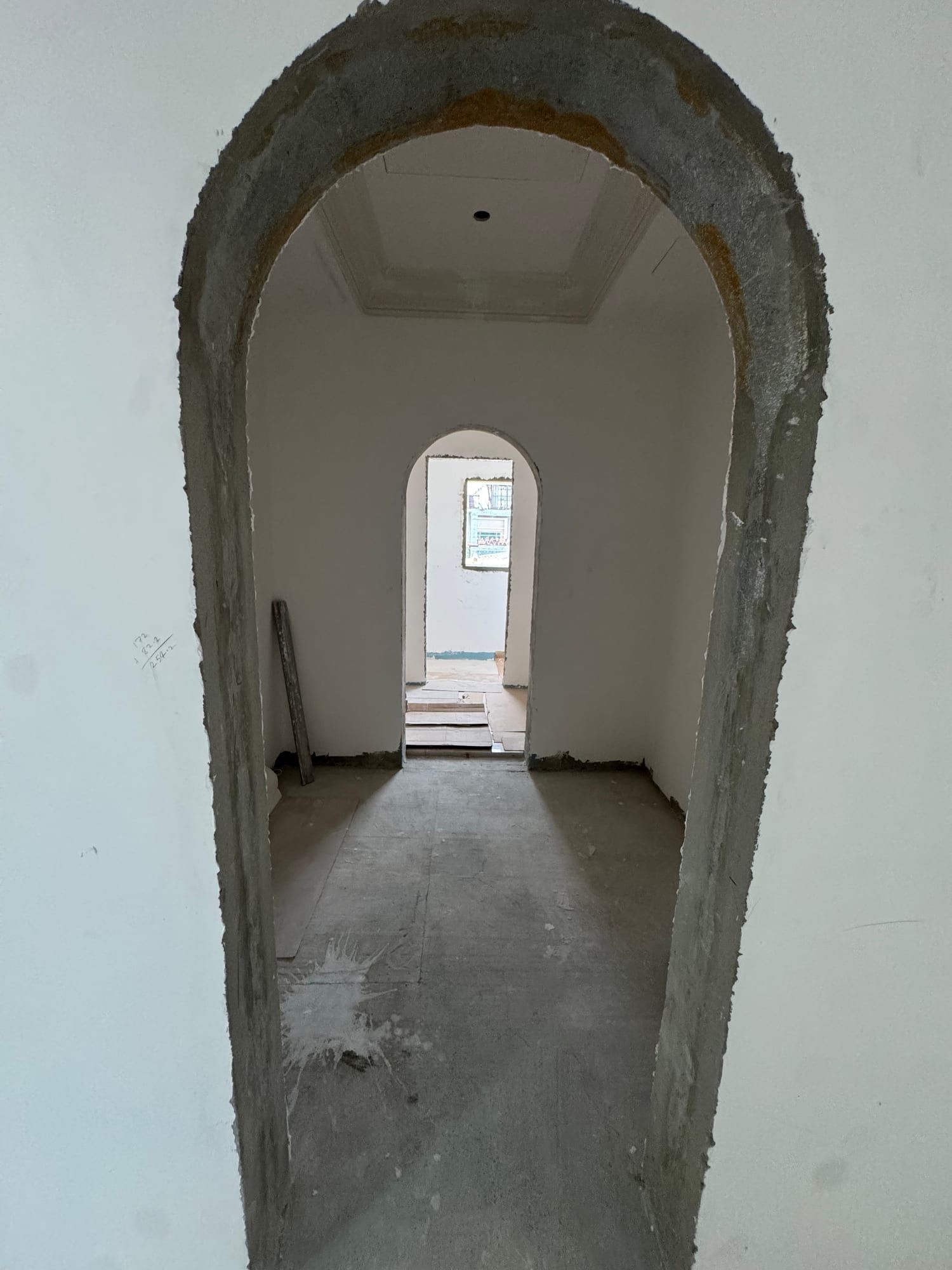

    • Arched opening with a raw plaster edge, looking through two rooms to a smaller arch beyond
      A new arched opening before its edge is finished
  3. Stage 3 · 2 mo · done

    Electrical and plumbing

    First fix for a villa of this size is a substantial job in itself: power, water, drainage, cooling and low-voltage runs for the smart systems, all set before anything closes. It is inspected and photographed while still open, because after plaster nobody can see it again.

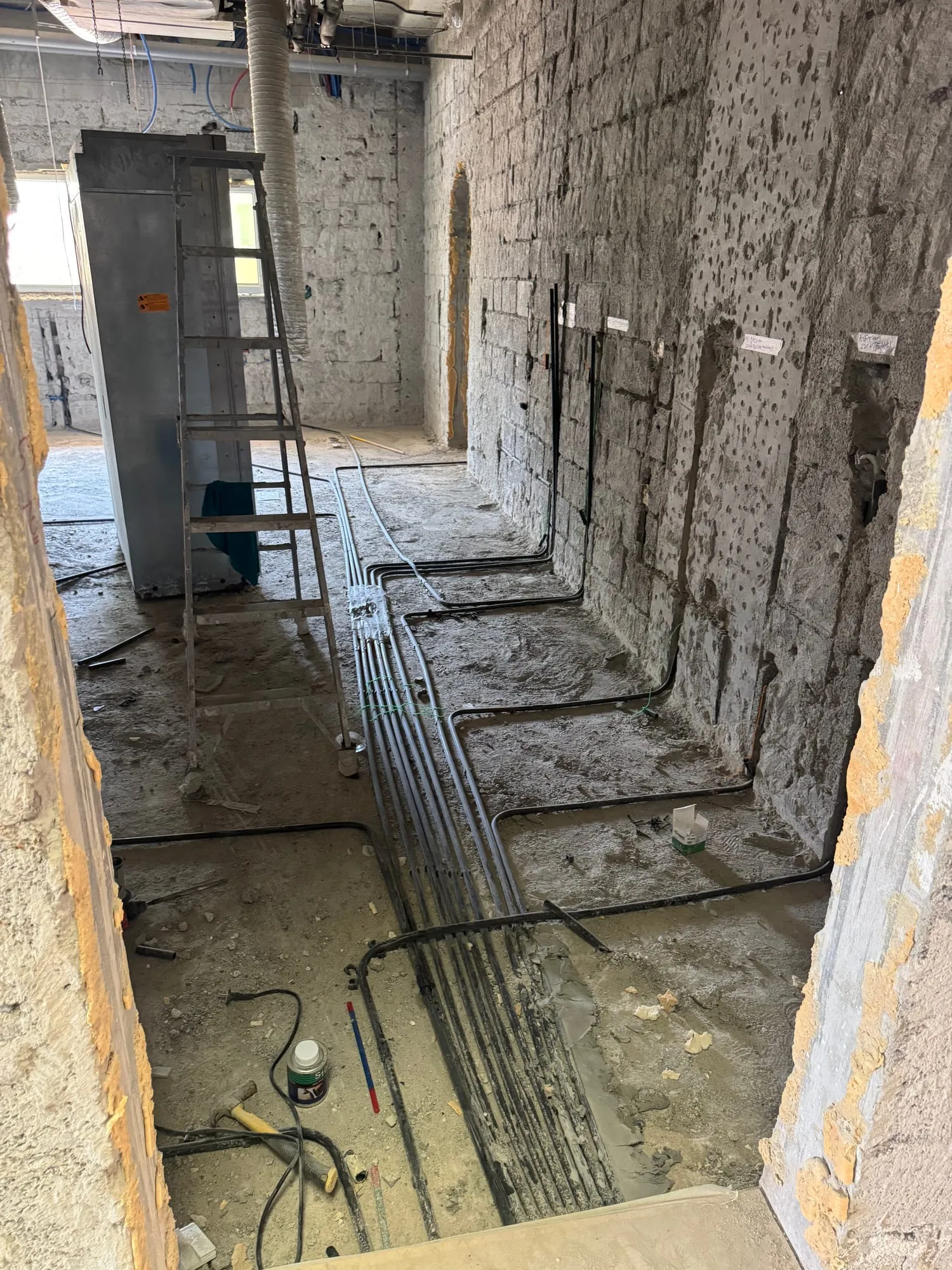

    • Corridor with conduit and pipe runs laid across the floor and chased into the stripped walls
      Service runs set before the floor and walls close over them

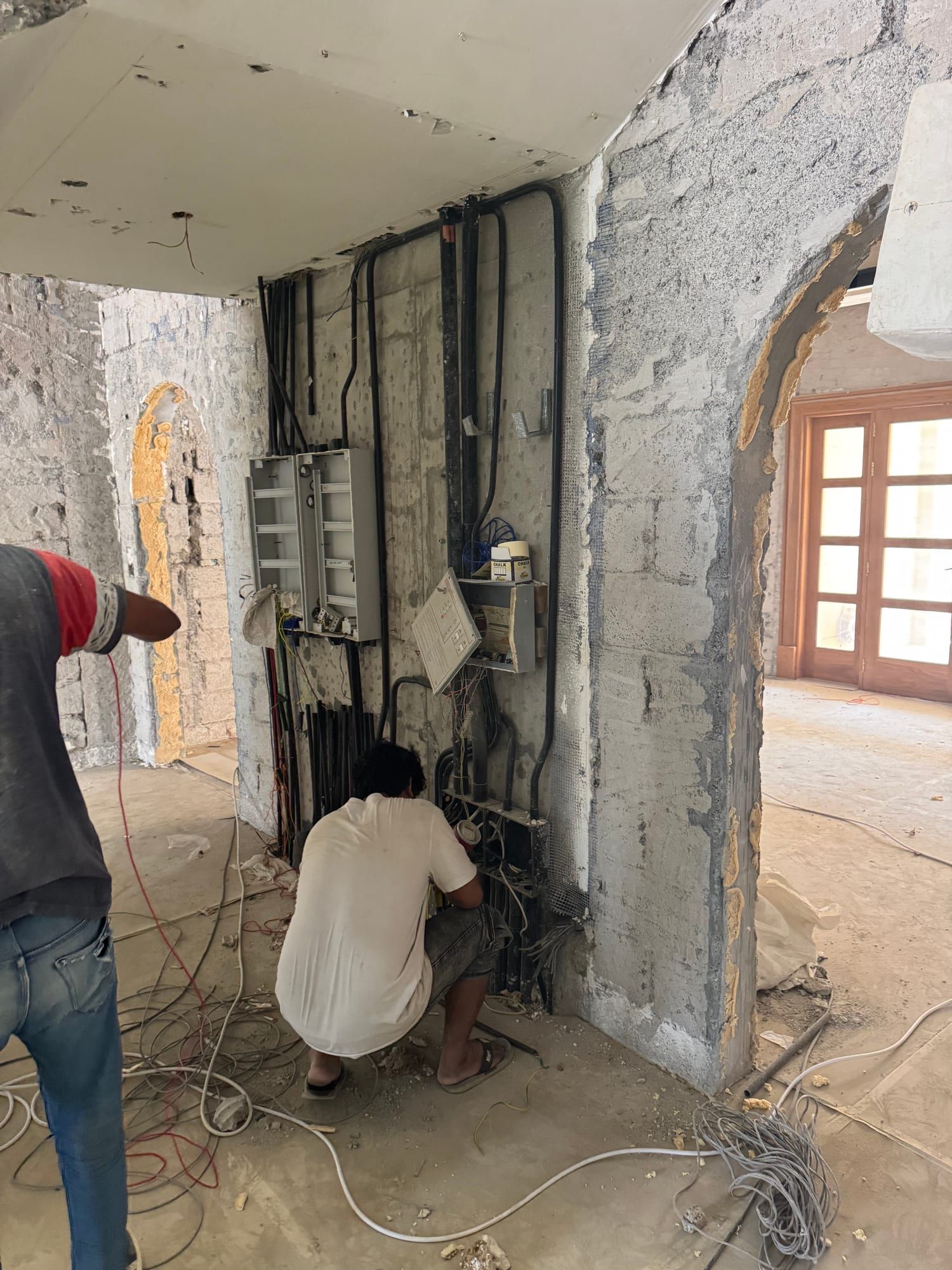

    • Two electricians working at a vertical run of new conduits and distribution boxes on a stripped wall
      Wiring brought to its distribution points
  4. Stage 4 · 3 mo

    Painting, ceilings, tiling, mouldings

    In progress now

    The longest stage, and the one where the villa starts to look like itself. Three-level ceilings are built and their mouldings run, tiling is set out so joints land where they should, and painted surfaces are prepared to a standard that will hold under the ceiling artwork.

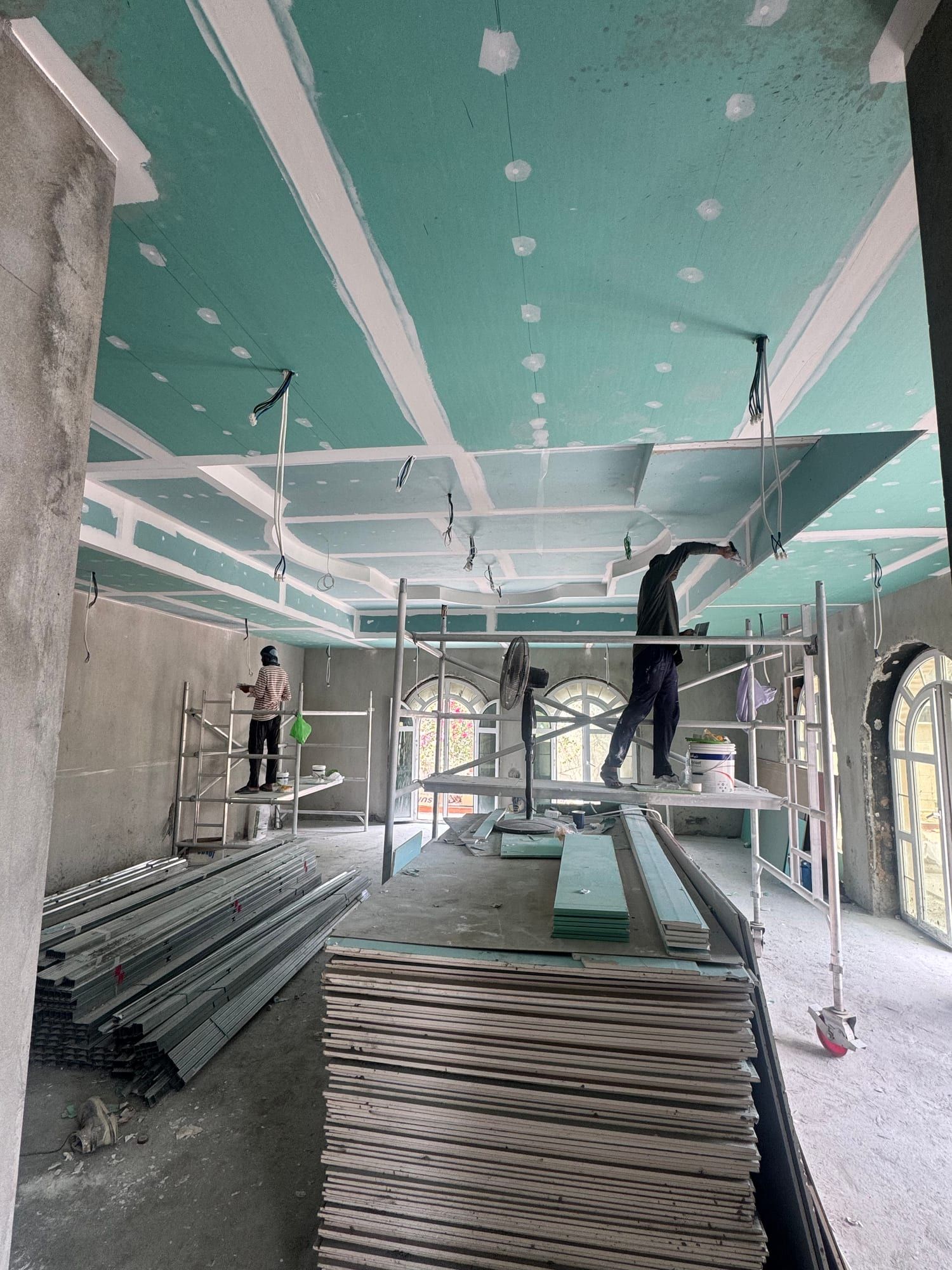

    • Workers on mobile scaffolds fixing green boards to a stepped ceiling, with stacks of boards on the floor
      Ceiling boards going up on the steel frame, April 2026
    • White ceiling with scrolled plaster ornaments set inside stepped levels

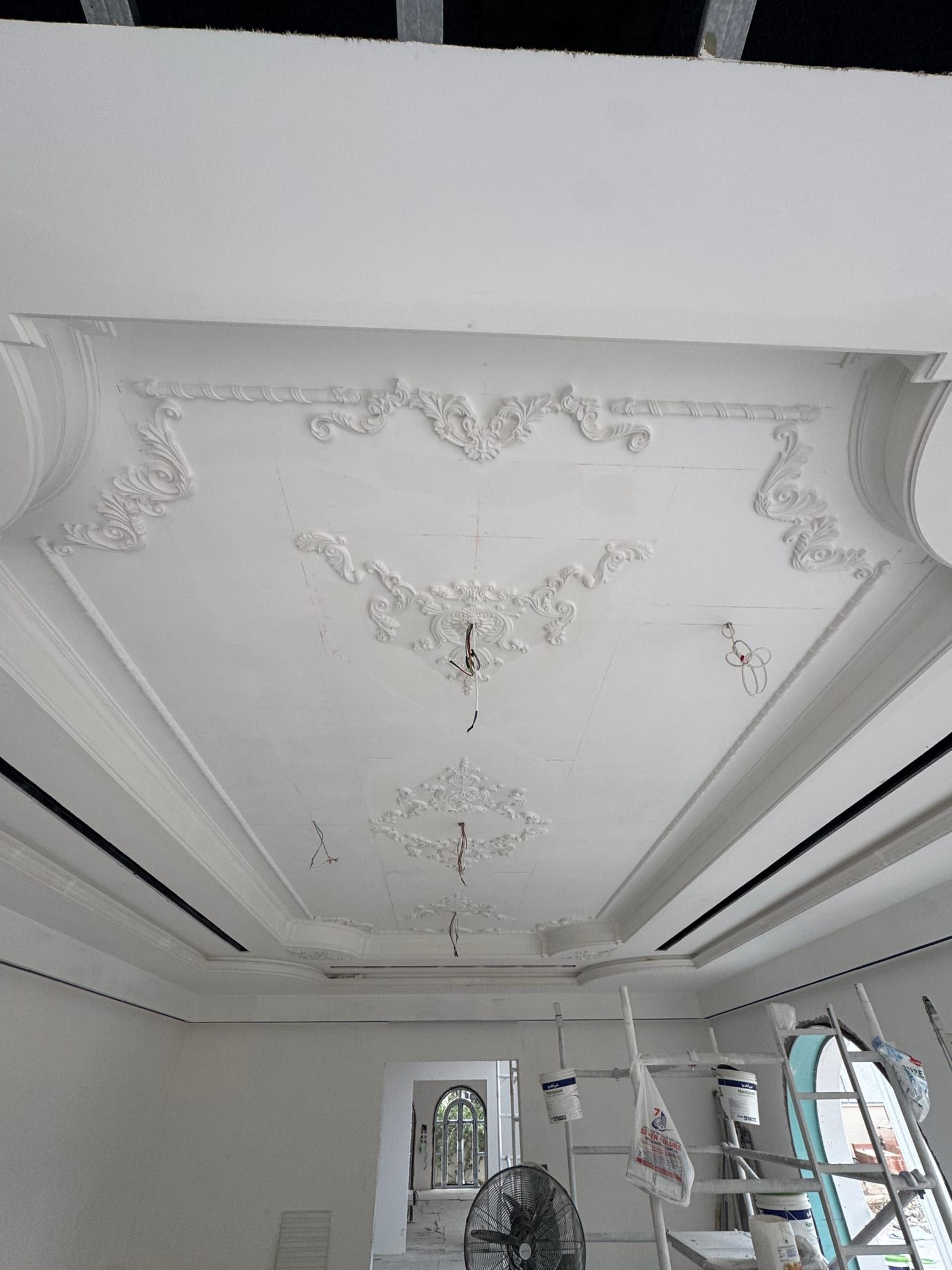

      Ornamental plaster fixed to the finished ceiling levels, July 2026
  5. Stage 5 · 2 mo

    Parquet, paint, second fix, furniture

    Parquet with its marble inlay goes down, final coats of paint go on, and electrical and sanitary fittings are installed. Bespoke furniture arrives in parallel — it was ordered months earlier against site dimensions, because production time does not wait for the site.

Four things that make this villa difficult

Anyone can install a floor. What separates one contractor from another is what happens when the drawing asks for something that does not go together easily.

Marble inlaid into the parquet

The task
A stone pattern set inside the wood floor rather than laid beside it, so the floor reads as one surface with a drawing in it.
Why it is hard
Wood and stone move differently and wear differently. Cut the modules loosely and the joint opens within a season; cut them tight without allowance and the parquet lifts.
How we do it
Modules are cut to the pattern and dry-laid before anything is fixed, so every joint is checked in place. Levels of stone and wood are brought flush, and the substrate is prepared to accept two materials that behave differently over time.

Three-level ceilings with mouldings

The task
Ceilings stepped in three planes, with run mouldings following each level.
Why it is hard
Every step multiplies the tolerance problem: a two-millimetre error at the first level is visible as a wave by the third, and mouldings are unforgiving of any deviation because the eye reads their line across the whole room.
How we do it
Levels are set from a single datum across the villa rather than room by room, and mouldings are dry-fitted along the run before fixing. Lighting is coordinated with the steps at drawing stage, not cut in afterwards.

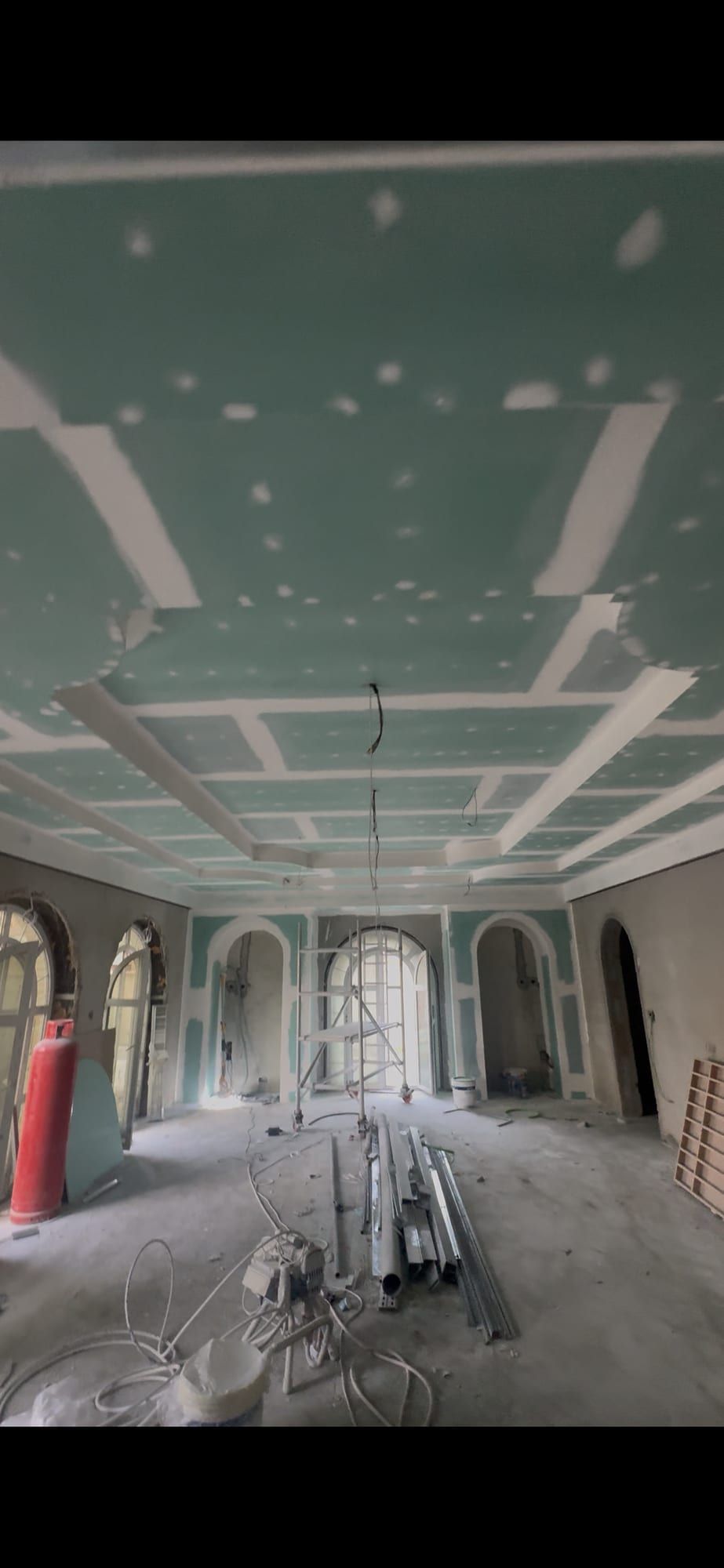

  • Stepped ceiling built in green board with its joints filled, above a room with arched windows
    Ceiling levels boarded and jointed before any moulding goes on

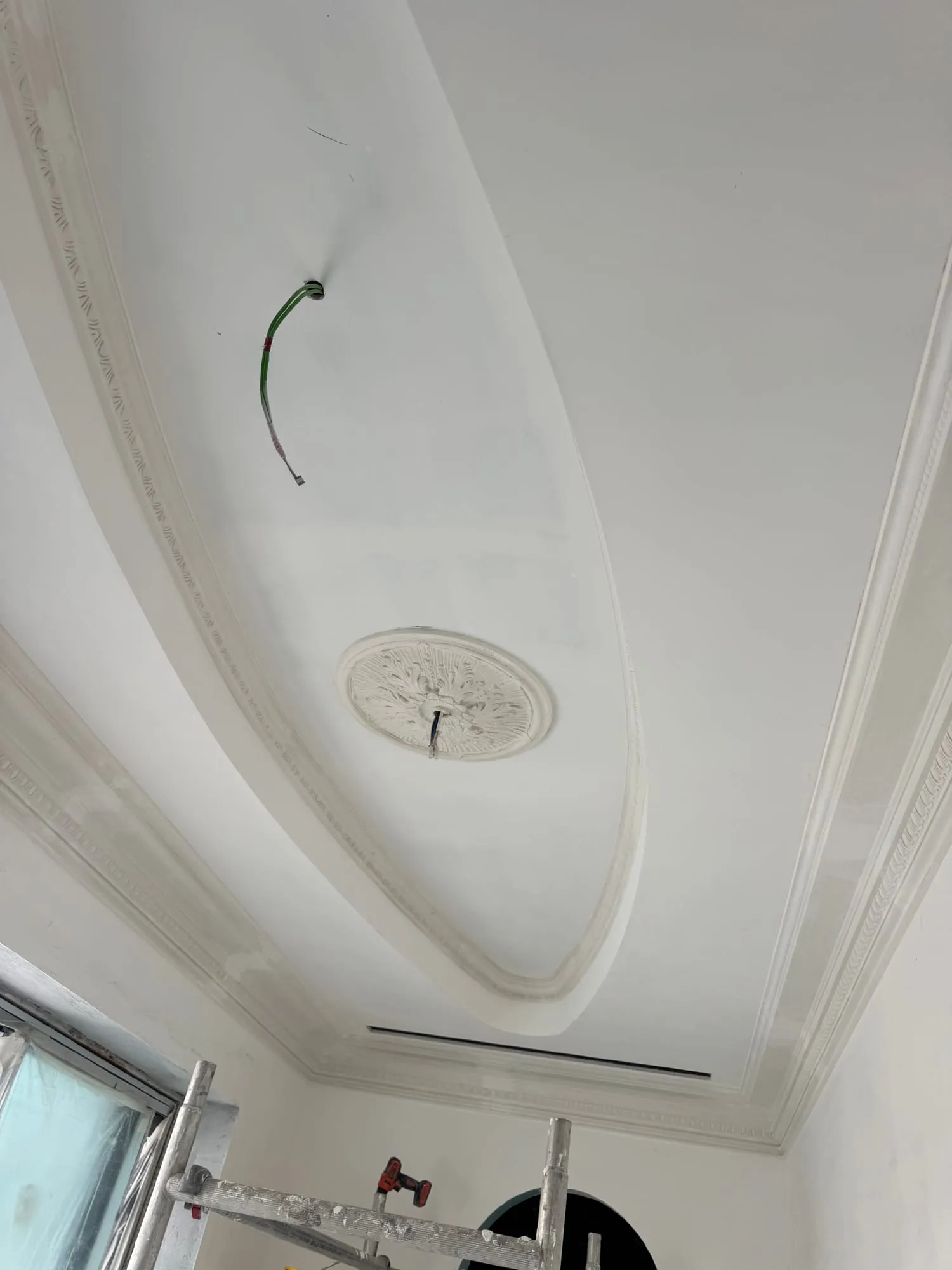

  • Oval ceiling recess edged with a run moulding, with a plaster medallion at its centre
    Mouldings and a medallion in place on a finished recess

Hand-painted ceilings

The task
Ceiling artwork painted in place by an artist, not applied as a print.
Why it is hard
The painting is the last thing that happens and the first thing that gets ruined. It needs a surface prepared to a higher standard than paint alone would require, a stable environment, and a site clean enough for an artist to work overhead for weeks.
How we do it
The ceiling is finished, lit and protected before the artist starts, and the programme reserves that window instead of squeezing the work between trades. Scaffolding and access are planned for the artist, not improvised.

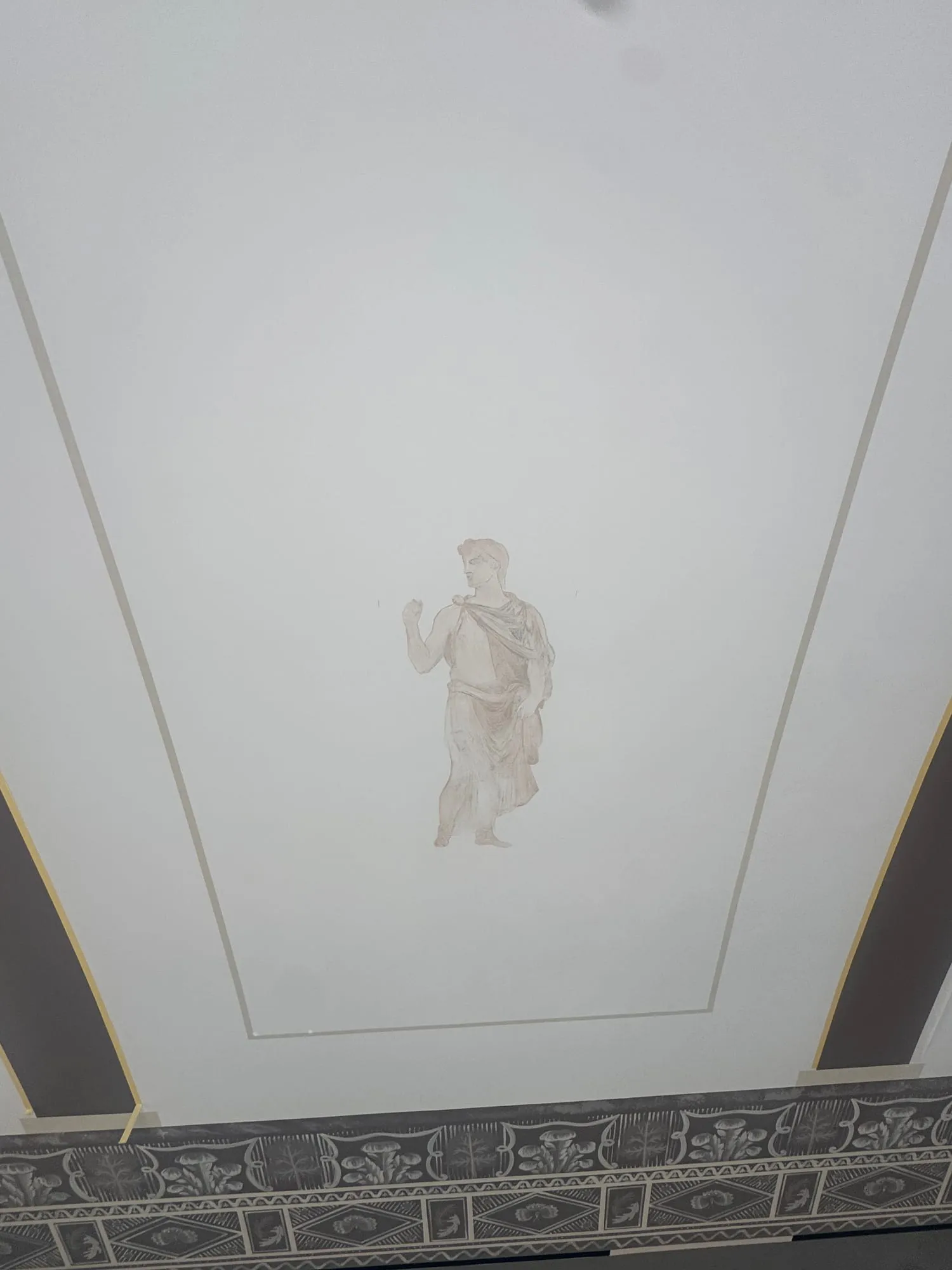

  • Ceiling panel with a figure painted in pale tones at an early stage, inside a thin painted frame
    A figure at its first layer

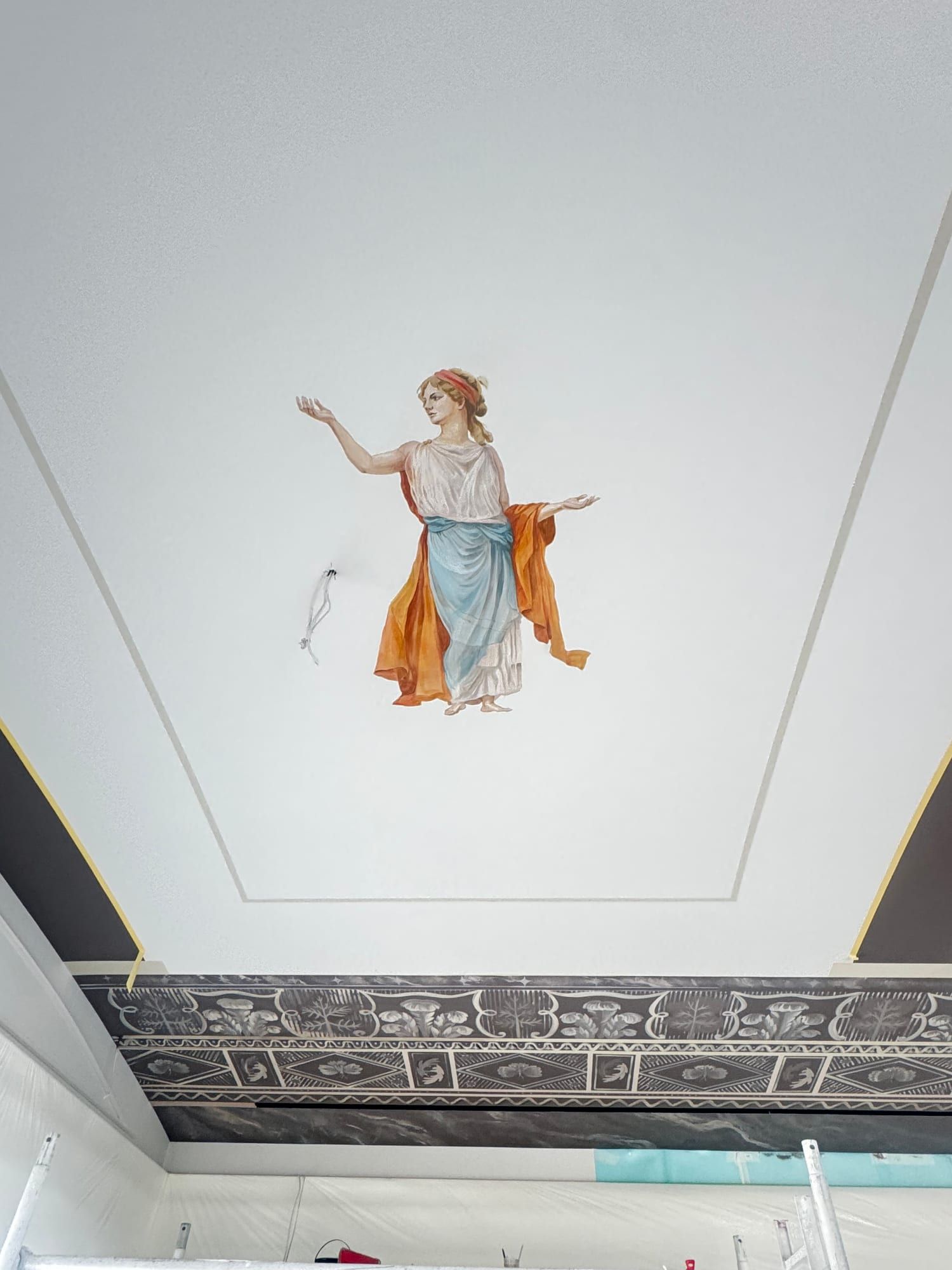

  • Painted figure of a woman in a blue and orange robe on a white ceiling panel
    A figure painted to full colour

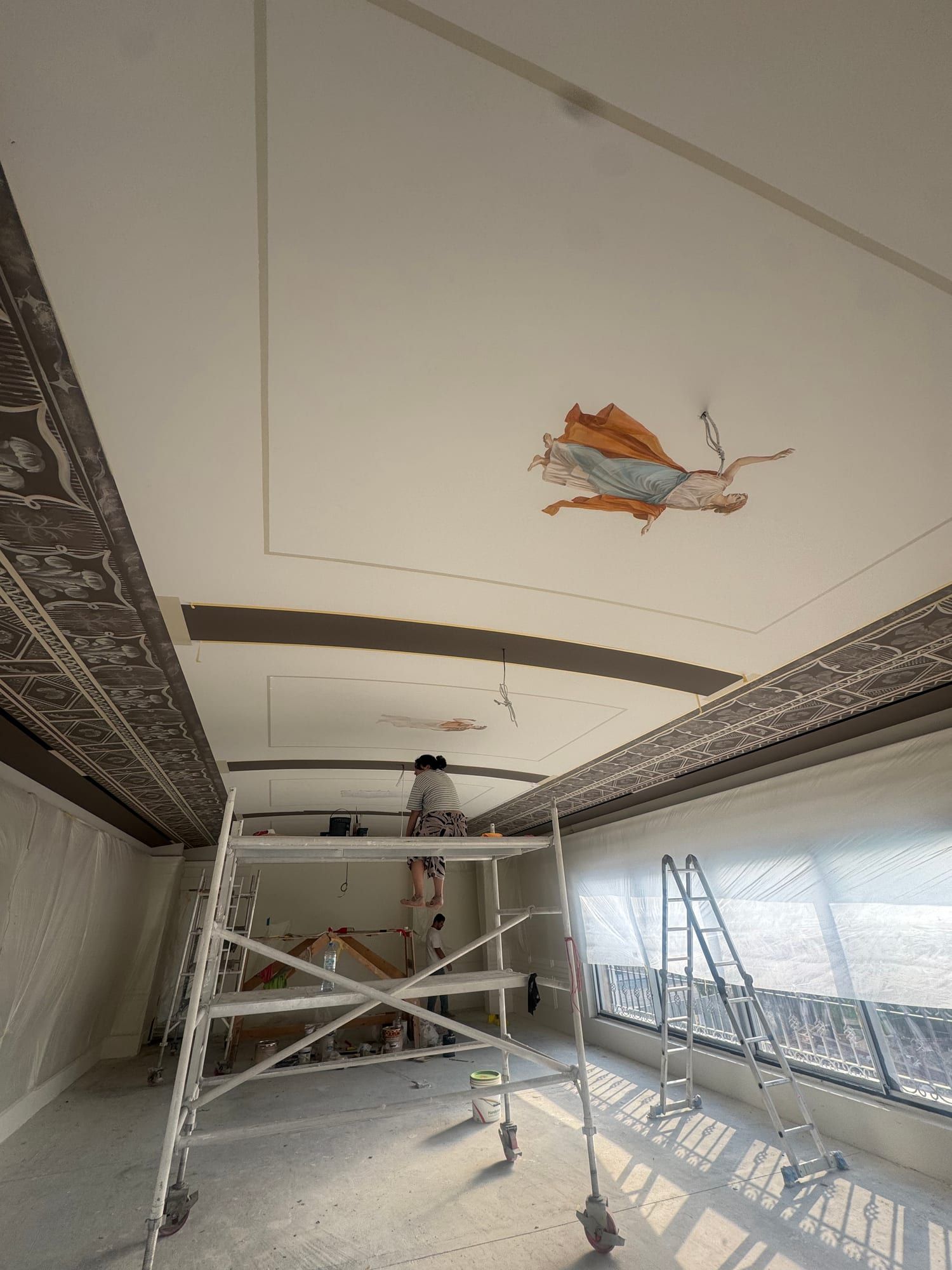

  • Artist on a mobile scaffold painting a figure onto the ceiling of a long room
    Painted in place, from a scaffold

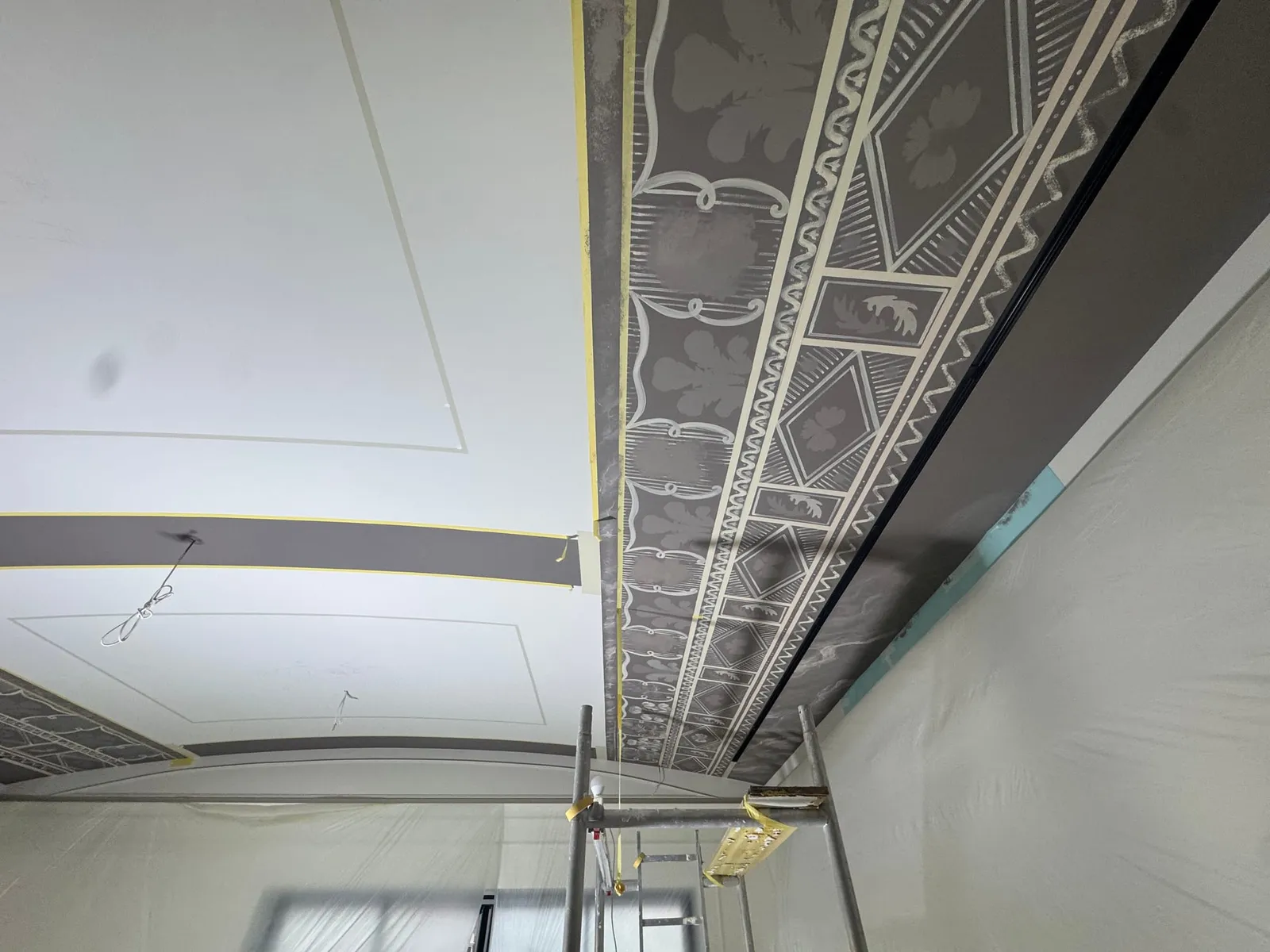

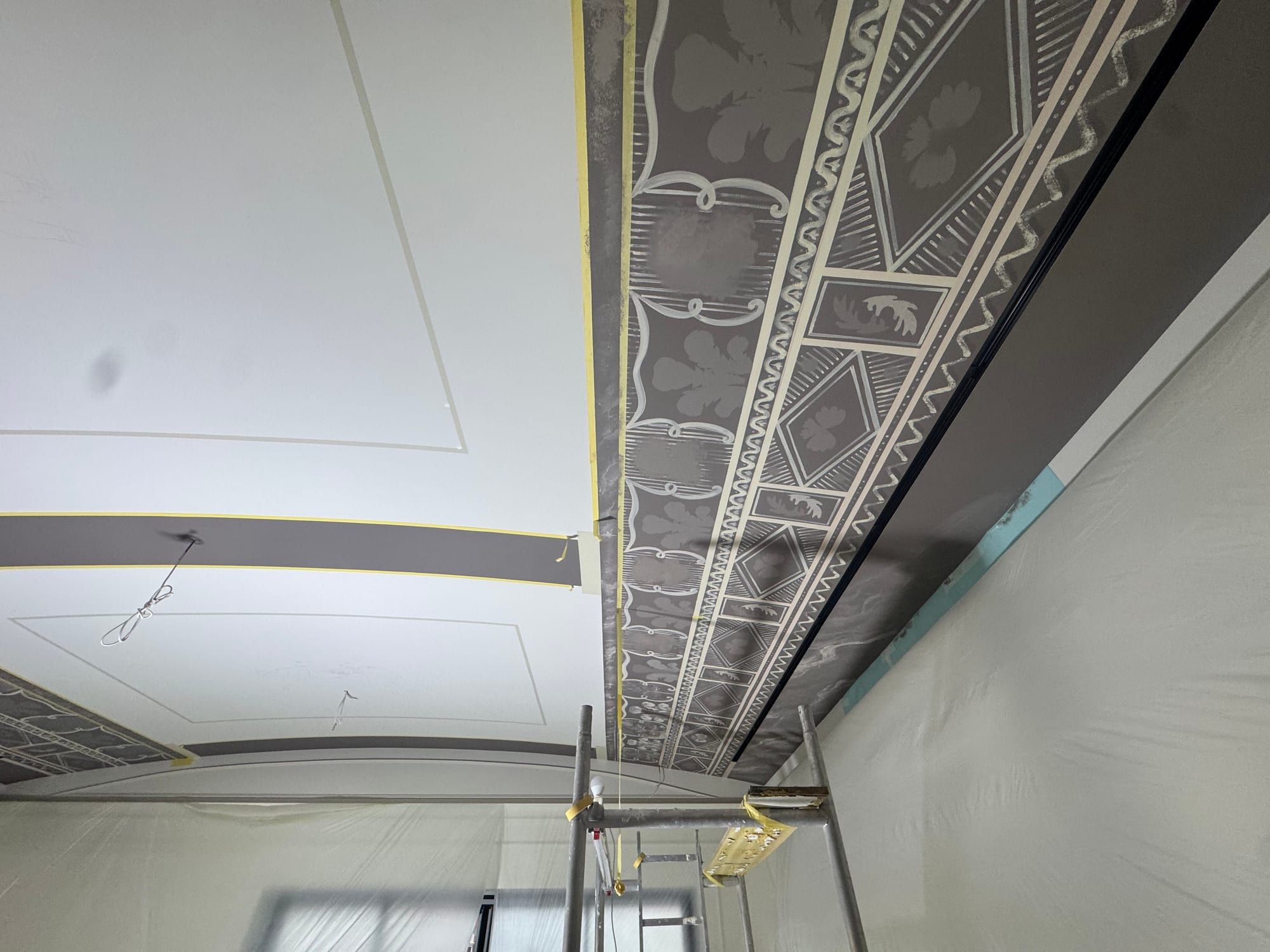

  • Monochrome ornamental band running along the edge of a ceiling above a wall
    The ornamental border along the ceiling edge

Natural materials throughout

The task
Stone, wood and plaster in their real form, across a villa of this size.
Why it is hard
Natural material varies from slab to slab and batch to batch. On 1,500 m² a colour shift between deliveries is not a detail — it is a visible line across a floor or a wall.
How we do it
Material is selected and reserved in one lot for each surface before work starts, and slabs are laid out and sequenced before cutting. What cannot be reserved in one lot is planned so that the transition falls at a junction, where the eye expects a change.

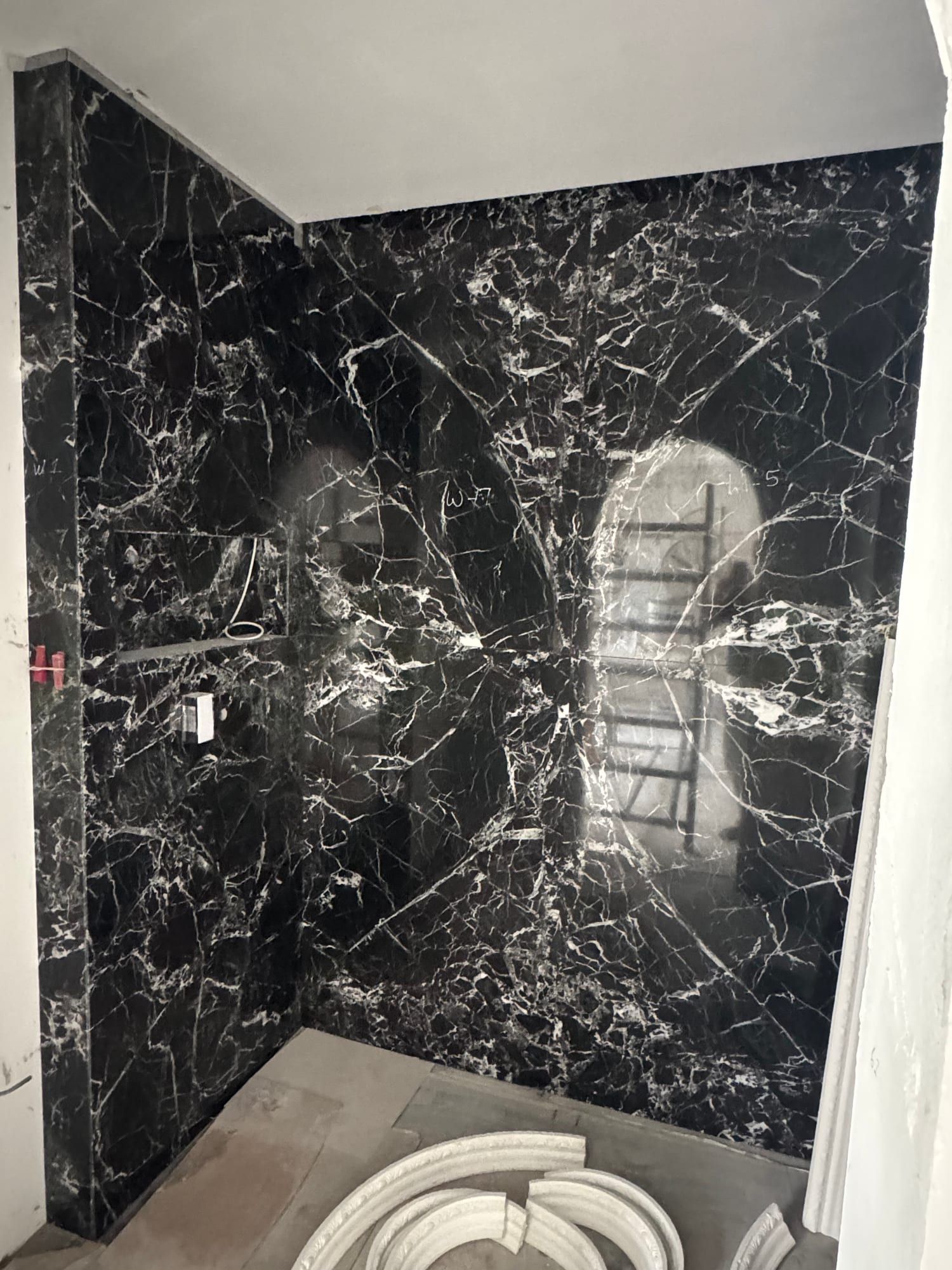

  • Bathroom wall clad floor to ceiling in dark stone with white veining, curved moulding pieces on the floor
    Dark veined stone set floor to ceiling in a bathroom
  • Upper gallery with a newly laid pale stone floor, a curved iron balustrade and a coffered ceiling

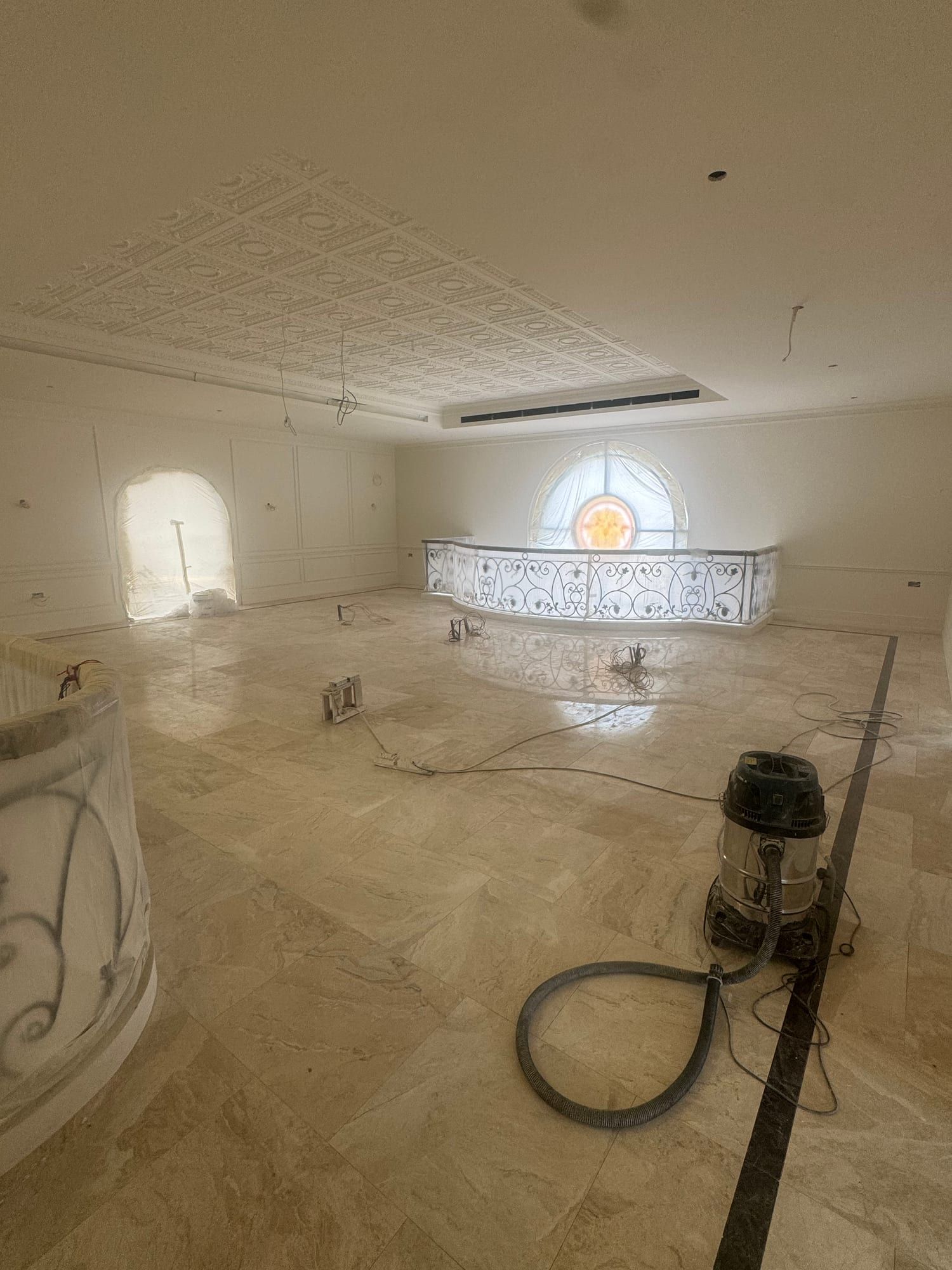

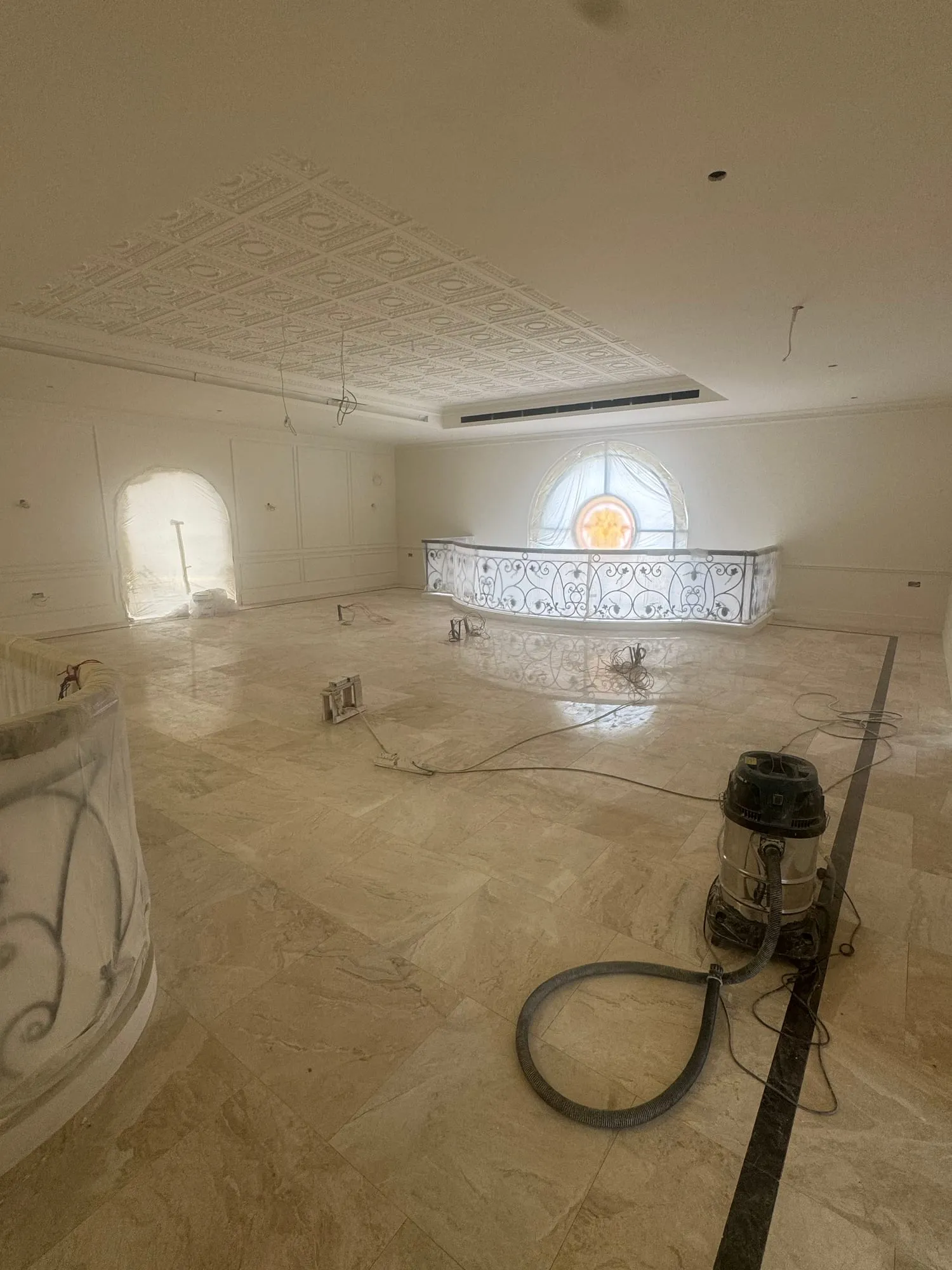

    Stone floor laid in the upper gallery, August 2026

Who is on site, and what we do ourselves

Between 10 and 35 people work on this villa depending on the stage. The peak falls on finishes, not on demolition — which is the opposite of what most owners expect.

Construction, services, finishing and the on-site coordination of every trade — the licence covers this work directly.

Bespoke furniture and finishing materials come through suppliers we hold dealerships with, which means the client pays the market price rather than a marked-up one.

What a villa like this costs

From 10,000 AED per m², turnkey. The figure moves with materials and brands at the finishing stage — the structure, services and labour behind it stay the same, which is why the honest way to quote is a bill of quantities rather than a rate.

For this villa, at 1,500 m², that puts the project in the order of 15 million dirhams and up. We take on villas from 700 m², which is where a full site team starts to make sense.

Come and see it

The site is working now. If you are choosing a contractor, an hour on an active villa tells you more than any portfolio.

We take on villa projects from 700 m² · from AED 7M.
